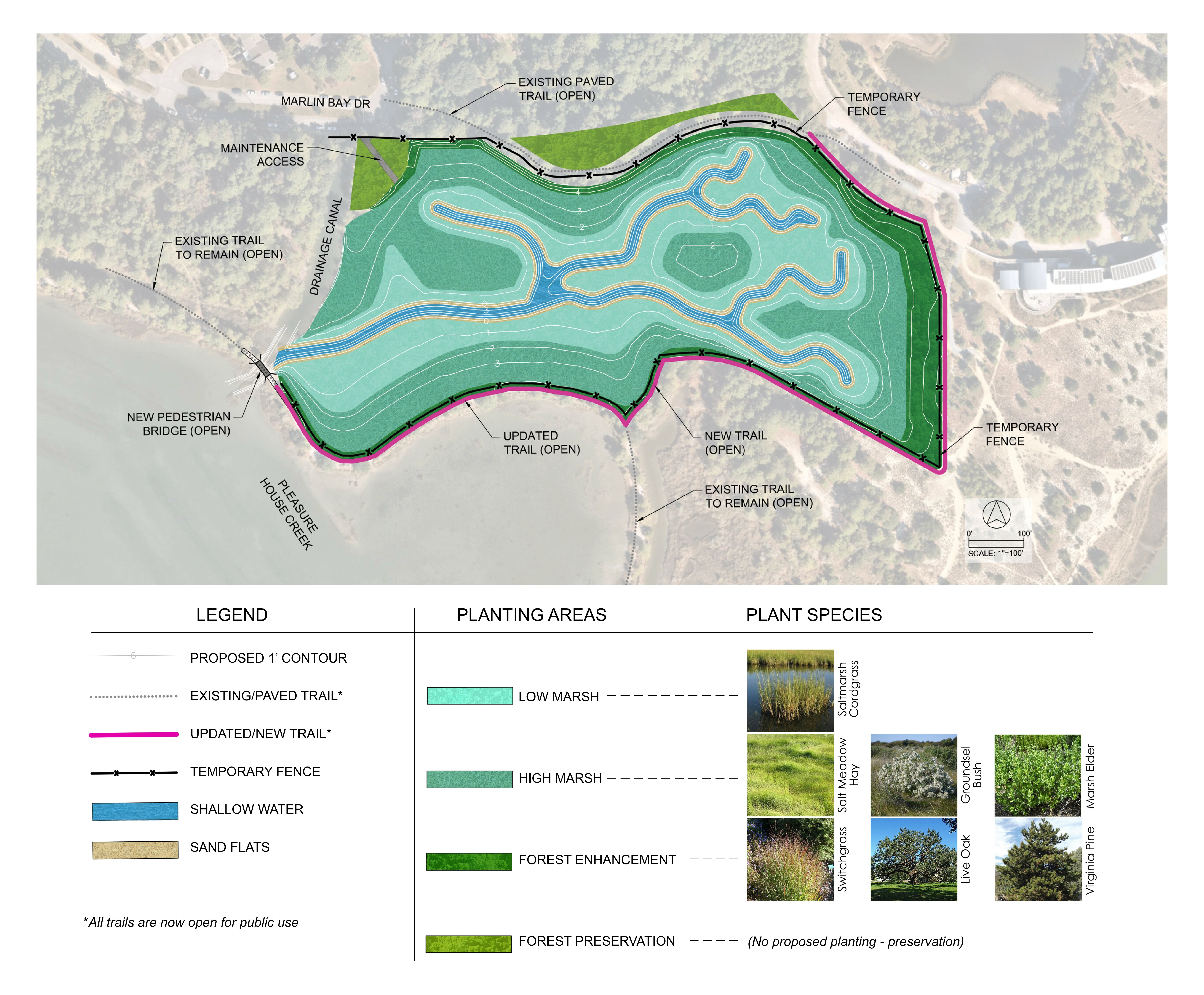

Pleasure House Point Wetlands Restoration Project
This project will return about eight acres back to its original tidal wetlands state, improving water quality and the health of the area’s ecosystem.
This project will return about eight acres back to its original tidal wetlands state, improving water quality and the health of the area’s ecosystem.
The project briefing was presented to City Council on Nov. 26, 2024. The Bayfront Advisory Commission was updated on Dec. 19, and City Council will vote on the transfer of funds on Jan. 7, 2025. A replay of the Bayfront Advisory Commission meeting is available.
If approved, mobilization and construction could begin in February 2025.
For questions about this project, please email phpwetlands@vbgov.com.
The Pleasure House Point Wetlands Restoration Project aims to restore eight acres of partially wooded land to its natural state of tidal wetlands. Natural tidal wetlands filter pollutants from entering our waterways, provide habitats for plants and animals, aid in flood protection, and contribute to the diversity of the unique area.
The project creates a sustainable solution for future City projects such as dredging, flood protection and roadway development, by mitigating wetlands usage and maintenance.
In addition to low lying wetlands grasses and plantings, over 600 trees will be planted including 336 live oaks and 192 water oaks.
Before the 1970’s, the area was partially wooded with a broad expanse of wetlands. Between 1971-1972, it’s estimated that over a million cubic yards of dredge material were placed over the wetlands, altering its natural state. In 2012, the City of Virginia Beach and partners preserved Pleasure House Point, protecting it from potential development.
Project Milestone
Cost
Project Milestone
Design:
Cost
$430,000
Project Milestone
Construction:
Cost
$11,525,000
Project Milestone
Long-term monitoring:
Cost
$135,000
Project Milestone
Total:
Cost
$12,090,000
Project Milestone
Timeline
Project Milestone
Design:
Timeline
November 2024-February 2025
Project Milestone
Construction:
Timeline
February 2025-October 2025
Project Milestone
First year monitoring:
Timeline
October 2025-October 2026
Project Milestone
Tenth year monitoring
Timeline
October 2035-October 2036
Project Milestone
Long-term monitoring
Timeline
October 2036
