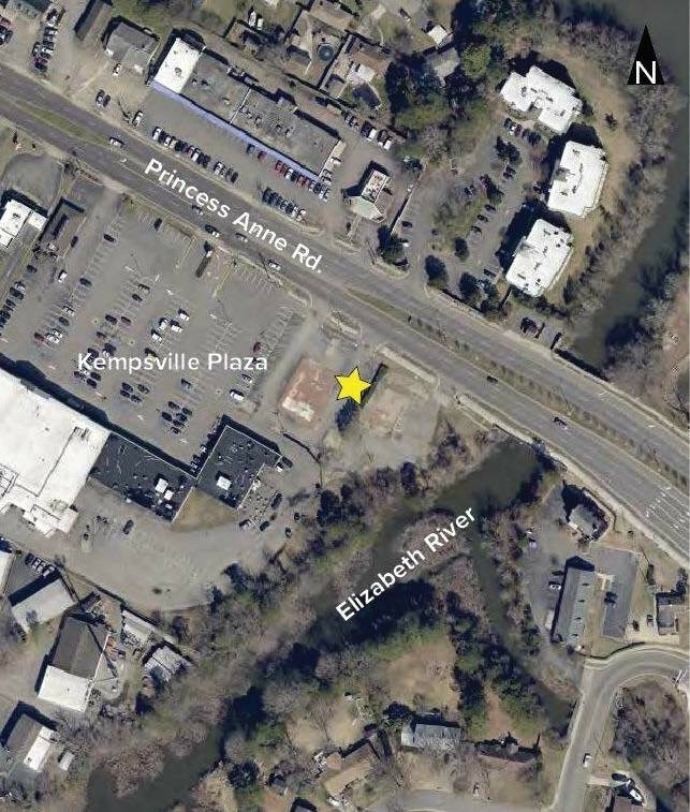

Project Status

Current Status & Next Steps

Construction started in March 2024. Erosion & sediment controls have been installed. Trees have been removed and existing building slabs were demolished. Storm pipe installation has started. Excavation for the water quality improvement construction and constructed wetland is anticipated to begin in Sept 2024. This project is funded by Capital Improvement Project (CIP) 100161.

Purpose of the Project

The benefits to the receiving channel’s ecosystem includes:

  • Reduced debris.
  • Reduced roadway pollutants.
  • Reduced algae-encountering nutrients flowing into the Elizabeth River.

Additionally, this project will contribute to the City’s requirement under the Chesapeake Bay total maximum daily load.

How the Project Achieves Purpose

This project will direct stormwater along Princess Anne Road through an underground water quality improvement structure, which will remove trash, sediment, and phosphorus. This flow is then directed through a constructed wetland that captures additional sediment and debris, as well as removing phosphorus and nitrogen before it drains into the eastern branch of the Elizabeth River.

Quick Facts

Project Cost

Design Cost

$190,000

Acquisition:

$55,000

Construction Cost:

$1,585,000

Total:

$1,830,000

Project Schedule

Design:

July 2023 to August 2023 (Complete)

Acquisition:

November 2017 to November 2022 (Complete)

Construction:

March 2024 to November 2025

Project Pollutant Removal Benefits

Total phosphorus removal:

10 pounds per year

Total nitrogen removal:

23 pounds per year

Total suspended solids removal:

5,000 pounds per year
